7.1.3.3 IfcConstructionResource

Ressource de construction
Konstruktion - Ressource

IfcConstructionResource is an abstract generalization of the different resources used in construction projects, mainly labour, material, equipment and product resources, plus subcontracted resources and aggregations such as a crew resource.

A resource represents "use of something" and does not necessarily correspond to a single item such as a person or vehicle, but represents a pool of items having limited availability such as general labor or an equipment fleet. A resource can represent either a generic resource pool (not having any task assignment) or a task-specific resource allocation (having an IfcTask assignment).

HISTORY  New entity in IFC2x2.
IFC4 CHANGE  Modified in to promote ResourceIdentifer and ResourceGroup (renamed to LongDescription) to supertype IfcResource and add attributes as described.

Declaration use definition

A root-level resource (specifically IfcCrewResource or IfcSubContractResource) is declared within the project by IfcRelDeclares where RelatingContext refers to the single IfcProject and RelatedObjects refers to one or more IfcConstructionResource, and other root-level objects within the project.

Assignment use definition

A resource may be assigned to an actor by IfcRelAssignsToActor where RelatingActor refers to an IfcActor and RelatedObjects refers to one or more IfcConstructionResource or other objects. Such relationship indicates the actor responsible for allocating the resource such as partitioning into task-specific allocations, delegating to other actors, and/or scheduling over time. Note that this assignment does not indicate the person or organization performing the work; that is indicated by IfcRelAssignsToResource. The actor responsible for the resource may or may not be the same as any actor(s) performing work.

A resource may be assigned to a control by IfcRelAssignsToControl where RelatingProduct refers to an IfcControl and RelatedObjects refers to one or more IfcConstructionResource or other objects. Most commonly an IfcWorkCalendar is assigned indicating availability of the resource, where such calendar is nested within a base calendar or an IfcWorkPlan which in turn is assigned to the IfcProject.

A resource may be assigned to a group by IfcRelAssignsToGroup where RelatingGroup refers to an IfcGroup and RelatedObjects refers to one or more IfcConstructionResource or other objects. Most commonly an IfcAsset is assigned indicating the asset to be tracked, where such asset is nested within an IfcInventory which in turn is assigned to the IfcProject.

A resource may be assigned to a product by IfcRelAssignsToProduct where RelatingProduct refers to an IfcProduct and RelatedObjects refers to one or more IfcConstructionResource or other objects. Most commonly an IfcElement subtype is assigned indicating the product to be constructed, where such product is connected to a spatial structure which in turn is aggregated within the IfcProject.

A resource may be assigned to a process by IfcRelAssignsToProcess where RelatingProcess refers to an IfcProcess and RelatedObjects refers to one or more IfcConstructionResource or other objects. Most commonly an IfcTask is assigned indicating the task to be performed by the resource, where such task is nested within a summary task which in turn is assigned to the IfcProject.

A resource may have assignments of other objects using IfcRelAssignsToResource where RelatingResource refers to the IfcConstructionResource and RelatedObjects refers to one or more objects such as IfcActor or IfcProduct subtypes. This relationship indicates specific objects assigned to fulfill resource usage.

Figure 40 illustrates resource assignment.

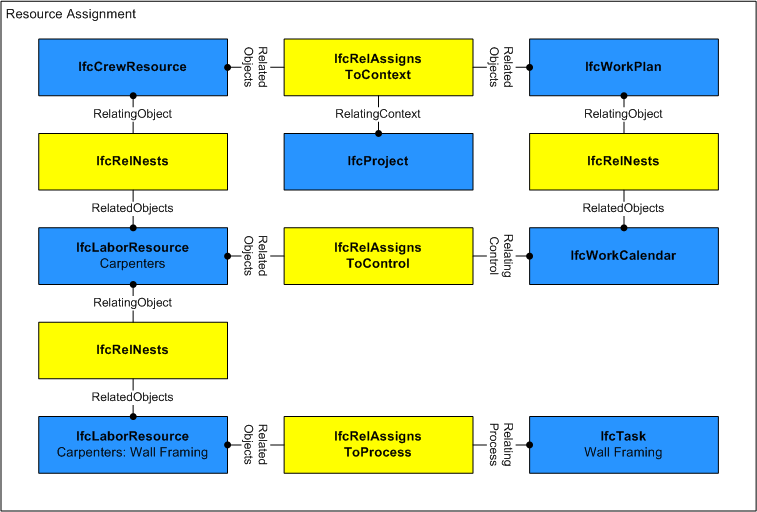

Assignment Use Definition

Figure 40 — Construction resource assignment use

Baseline use definition

A resource may have any number of baselines defined using the relationship IfcRelDefinesByObject where RelatingObject is the "current" resource and RelatedObjects consists of multiple "baseline" resources, each representing a copy of the resource as it existed at an earlier point in time as shown in Figure 185. Each baseline IfcConstructionResource is identified by its nested IfcRelAssignsToControl relationship to an IfcWorkSchedule having PredefinedType=BASELINE, IfcWorkSchedule.CreationDate indicating the date of the baseline, and IfcWorkSchedule.Name indicating the name of the baseline.

Baseline Use Definition

Figure 41 — Construction resource baseline use

XSD Specification:

 <xs:element name="IfcConstructionResource" type="ifc:IfcConstructionResource" abstract="true" substitutionGroup="ifc:IfcResource" nillable="true"/>
 <xs:complexType name="IfcConstructionResource" abstract="true">
  <xs:complexContent>
   <xs:extension base="ifc:IfcResource"/>
  </xs:complexContent>
 </xs:complexType>

EXPRESS Specification:

ENTITY IfcConstructionResource
ABSTRACT SUPERTYPE OF(IfcConstructionProductResource)
SUBTYPE OF (IfcResource);
Usage : OPTIONAL IfcStrippedOptional;
BaseCosts : OPTIONAL LIST [1:?] OF IfcStrippedOptional;
BaseQuantity : OPTIONAL IfcStrippedOptional;
END_ENTITY;

Attribute Definitions:

BaseQuantity : Identifies the base quantity consumed of the resource relative to assignments. For crew, labour, subcontract, and equipment resources, this refers to IfcQuantityTime. For material resources, this refers to IfcQuantityVolume. For product resources, this refers to IfcQuantityCount.
IFC4 CHANGE  New attribute.

Inheritance Graph:

ENTITY IfcConstructionResource
ENTITY IfcRoot
GlobalId : IfcGloballyUniqueId;
OwnerHistory : OPTIONAL IfcOwnerHistory;
Name : OPTIONAL IfcLabel;
Description : OPTIONAL IfcText;
ENTITY IfcObjectDefinition
INVERSE
HasAssignments : SET OF IfcRelAssigns FOR RelatedObjects;
HasContext : SET [0:1] OF IfcRelDeclares FOR RelatedDefinitions;
IsDecomposedBy : SET OF IfcRelAggregates FOR RelatingObject;
Decomposes : SET [0:1] OF IfcRelAggregates FOR RelatedObjects;
HasAssociations : SET OF IfcRelAssociates FOR RelatedObjects;
ENTITY IfcObject
ObjectType : OPTIONAL IfcStrippedOptional;
INVERSE
IsTypedBy : SET [0:1] OF IfcRelDefinesByType FOR RelatedObjects;
IsDefinedBy : SET OF IfcRelDefinesByProperties FOR RelatedObjects;
ENTITY IfcResource
Identification : OPTIONAL IfcStrippedOptional;
LongDescription : OPTIONAL IfcStrippedOptional;
INVERSE
ENTITY IfcConstructionResource
Usage : OPTIONAL IfcStrippedOptional;
BaseCosts : OPTIONAL LIST [1:?] OF IfcStrippedOptional;
BaseQuantity : OPTIONAL IfcStrippedOptional;
END_ENTITY;

Link to this page  Link to this page
